Roosevelt Park Money on Tuesday's Agenda: What the Council Packet Shows

Two orders would move $2,230,219.50 from the Roosevelt Park Revitalization Project to the Malden River Works. MNN compared information on the Tuesday October 6 meeting against the City Council's earlier December 2025 presentation.

On Tuesday, October 6, the City Council's agenda includes two orders that would move a combined $2,230,219.50 out of the Roosevelt Park Revitalization Project and into the Malden River Works. Both are sponsored by Finance Chair Carey McDonald.1 The money would help pay for Phase 2 of the River Works, the boathouse and salt shed, which the city's own presentation says is not yet fully funded.2

MNN's September 29 email to the Council, nine questions signed by Brian DeLacey and Bill Muise, is attached to both orders.3 This story reads the full packet and compares the city's September 2026 River Works presentation with the version presented to the Council on December 16, 2025.4

What the orders say

In a September 22 memo attached to the orders, Mayor Gary Christenson wrote that the River Works had been funded "entirely through grants and outside funds" until now, that the money to finish the boathouse and salt shed is insufficient, and that it is appropriate for the city to share some of the cost. He recommended reappropriating funds left over from the cancelled Roosevelt Park project, which he said are not part of the funding for the work currently planned there, and called that a better option than a new borrowing or drawing on reserves.5

Money Moves 2025 -> 2026.

What the River Works presentation shows

Phase 2 (boathouse and salt shed), September 2026 presentation
ItemAmount
Vertical construction (professional estimate)$4,118,500.00
designLAB/Landing Studio costs (actual)$397,840.00
Nangle costs, 8/5/26 (actual)$64,100.00
Other soft costs, OPM (estimate)$123,555.00
8% construction contingency$329,480.00
Total estimated cost$5,033,475.00
Carryover grant funding, Gateway (actual)$738,723.26
Section 108 loan (actual)$1,500,000.00
Bayrd Foundation grant (actual)$500,000.00
State earmark (potential)$100,000.00
City funds (potential)$2,230,219.50
Total potential funding$5,068,942.76

The City Funds line equals the sum of the two orders, about 44 percent of the potential funding for Phase 2. Total potential funding exceeds the estimated cost by $35,467.76, and that cushion depends on the $100,000 state earmark, which is labeled potential. Without it, the table would be $64,532.24 short. The slide itself says not all of the numbers are actuals, and that bidding Phase 2 will determine its real cost.2

Nine months earlier

The December 16, 2025 presentation used a similar template in part, and showed a smaller gap. It put the Phase 2 cost estimate at $4,159,859 against $3,140,232.85 in potential funding, leaving a remaining potential gap of $1,019,626.15, and listed no city funds.4 The September request is $1,210,593.35 more than that gap, about 2.2 times as much.

River Works presentations compared. September soft costs combine the designLAB, Nangle and OPM lines.
LineDecember 2025September 2026Change
Phase 2 vertical construction estimate$3,381,999$4,118,500+$736,501 (+21.8%)
Phase 2 soft costs$507,300$585,495+$78,195
Phase 2 contingency (8%)$270,560$329,480+$58,920
Phase 2 total cost$4,159,859$5,033,475+$873,616 (+21.0%)
Carryover grant funding$1,140,232.85 (potential)$738,723.26 (actual)-$401,509.59
Section 108 loan$1,500,000 (potential)$1,500,000 (actual)No change in amount
Bayrd Foundation grant$500,000 (potential)$500,000 (actual)No change in amount
State earmarkNone listed$100,000 (potential)+$100,000
City fundsNone listed$2,230,219.50 (potential)+$2,230,219.50
Phase 1 total$11,802,633.15$12,035,822.30+$233,189.15
Total funding received$12,988,888.33$14,988,888.33+$2,000,000.00

By MNN's arithmetic from the two presentations, a Phase 2 cost increase of $873,616 and a $401,509.59 drop in carryover funding, partly offset by the new $100,000 state earmark, add up to a $1,175,125.59 gap before any city money. The remaining $35,467.76 of the $1,210,593.35 difference is the cushion described above.

Several other details changed or stayed put:

Outside funds and city funds

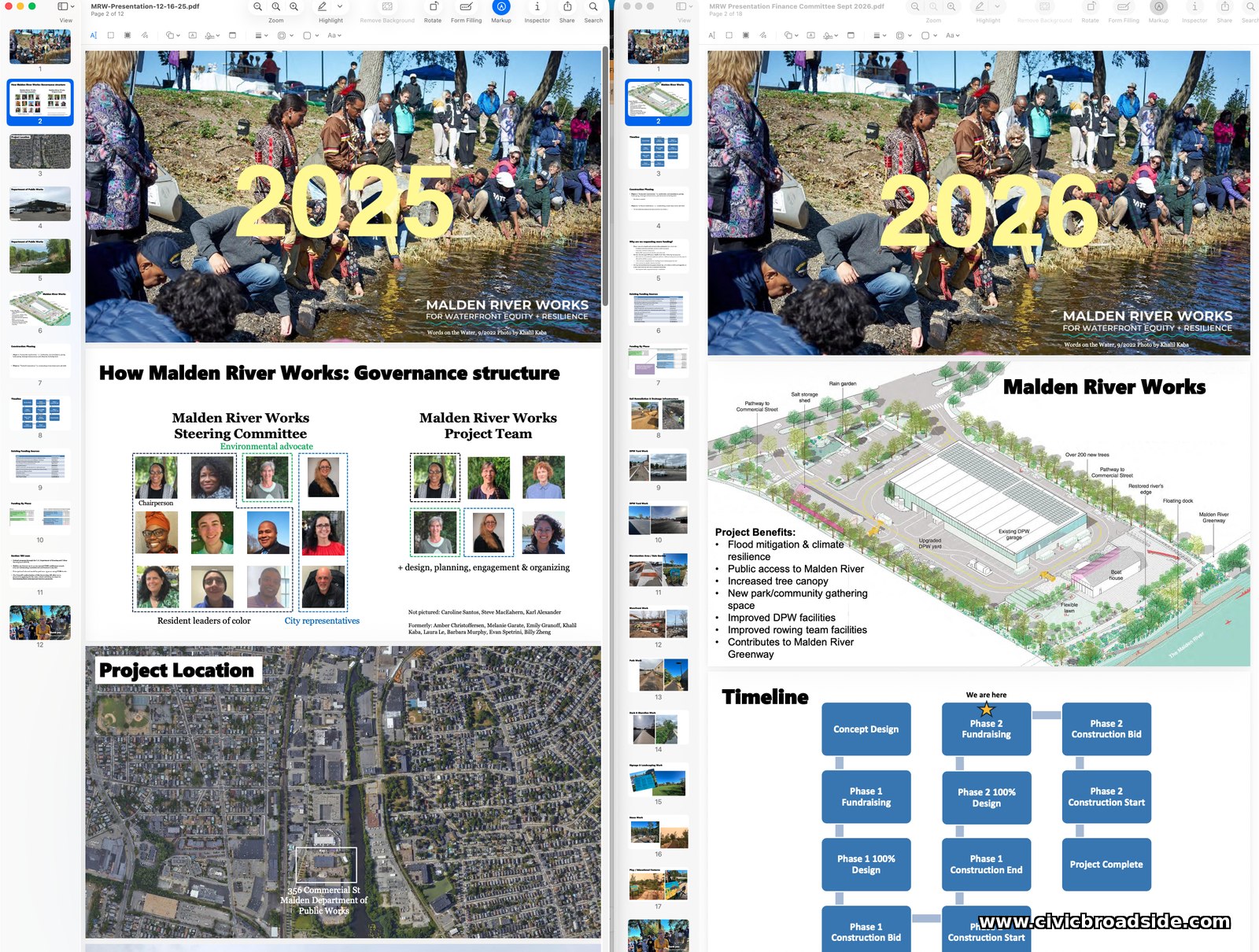

Governance Gone 2025 -> 2026?
The governance slide was left out of the September 2026 presentation now before the City Council.

The September presentation says the project has so far not needed to "dip into City funds," and the mayor's memo describes the funding as grants and outside money. The same presentation's list of funding received includes $1,000,000 from the Malden Community Preservation Committee and a $1,500,000 Section 108 loan.2 The December presentation described Section 108 as a HUD loan the city would repay over 15 years from federal Community Development Block Grant funds, with payment amounts to be determined after the loan application.4

Whether those lines count as city funds depends on a definition the packet does not supply, and it does not state the annual loan payment. MNN's email also asked about a $1,450,000 Community Preservation-backed borrowing, $1,000,000 of which was reallocated to the River Works.3 The packet does not say whether the $1,000,000 Community Preservation line in the presentation is that money.

The Roosevelt Park side

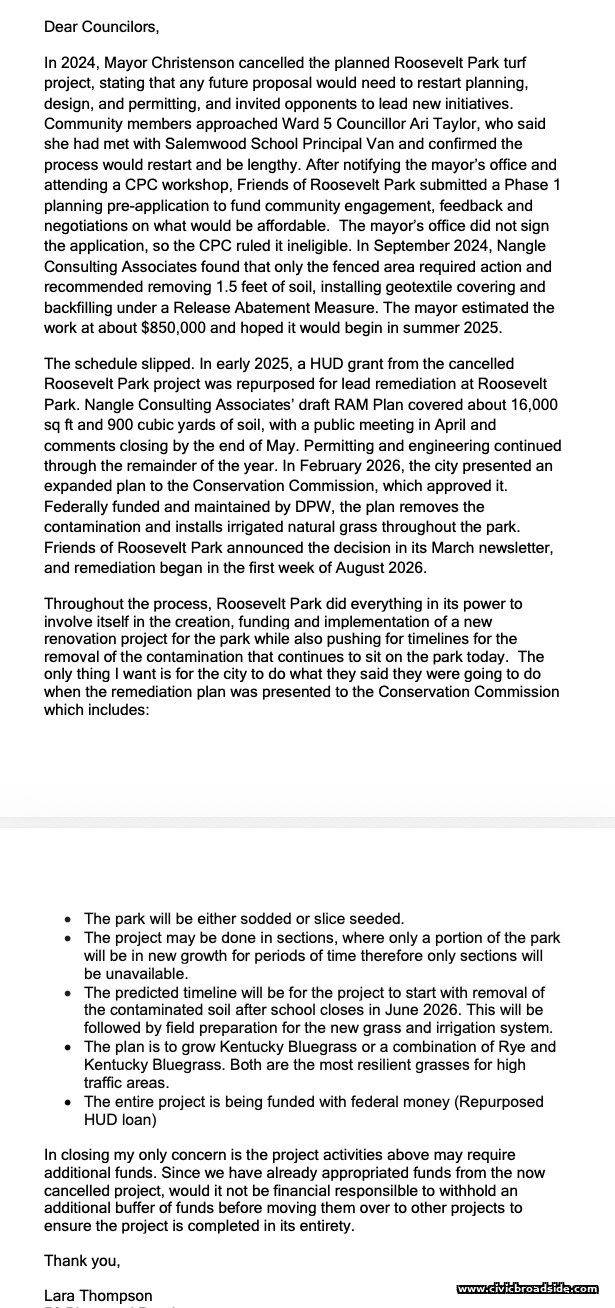

The only document in the packet about work at Roosevelt Park itself is a letter to the Council from a neighbor of the park.6 It recounts the 2024 cancellation of the turf project, a September 2024 consultant finding that only the fenced area required action, a February 2026 expanded plan approved by the Conservation Commission, and the start of remediation in the first week of August 2026. The plan it describes is federally funded, maintained by the Department of Public Works, and installs irrigated natural grass throughout the park. The writer calls the funding a repurposed HUD loan, and says the plan called for work to start after school let out in June.

Her concern is that these activities may need more money than is budgeted. She asks whether it would be financially responsible to hold back a buffer before moving funds from the cancelled project to other projects. The letter is one resident's account, and MNN has not independently verified its details.

None of the four attachments gives a current cost estimate for finishing the Roosevelt Park work, or a plan, cost or funding source for elements cut from the original project, such as the outdoor classroom.

MNN's nine questions and the packet

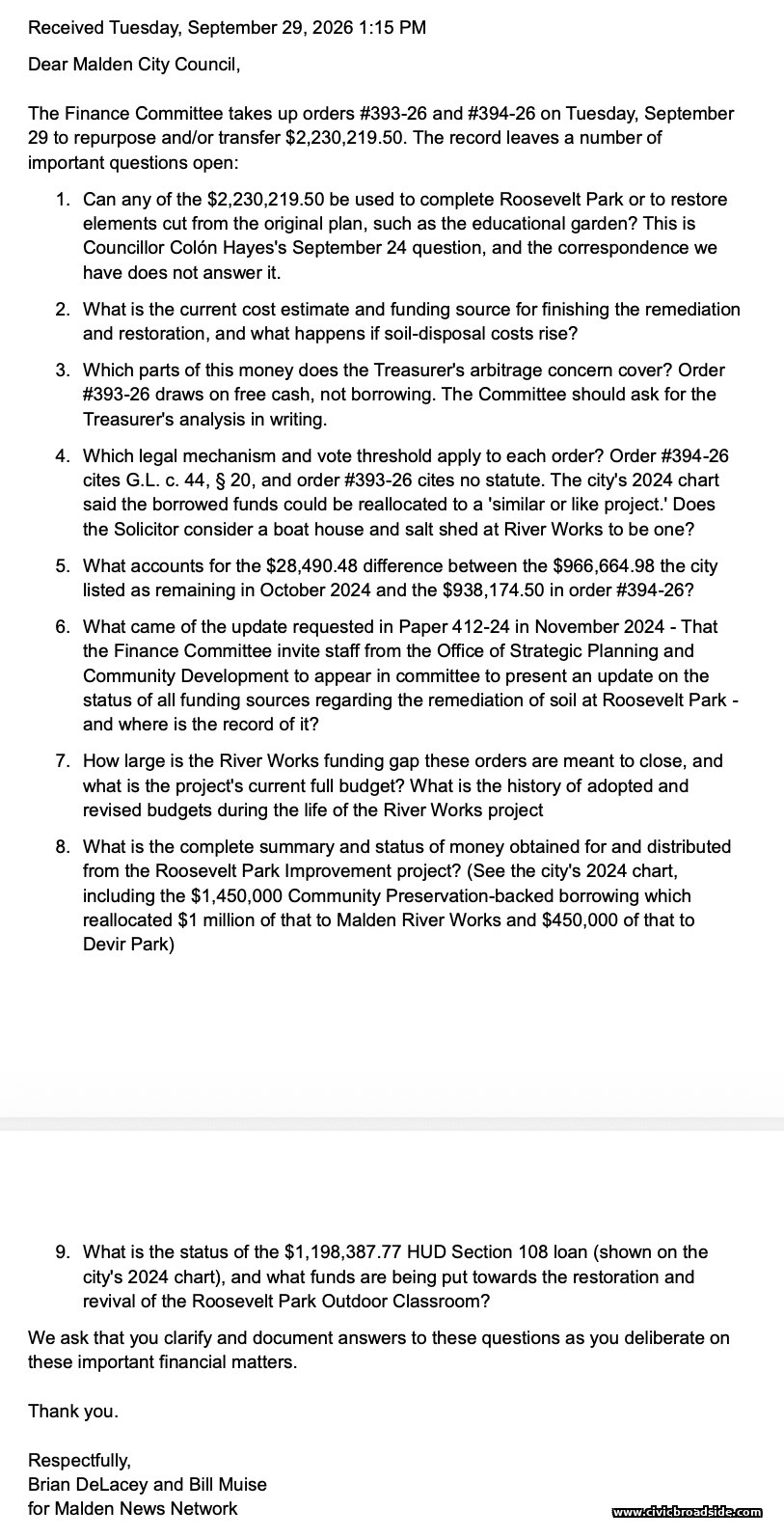

What the agenda attachments show on each question in MNN's September 29 email
#QuestionWhat the attachments show
1Can any of the $2,230,219.50 complete Roosevelt Park or restore cut elements such as the outdoor classroom?The mayor's memo says the funds are not part of currently planned work there. Nothing addresses restoring cut elements.
2What is the current cost estimate and funding source for finishing remediation and restoration, and what if disposal costs rise?No cost estimate. The resident letter describes federal funding and raises the risk of added costs.
3Which money does the Treasurer's arbitrage concern cover?No Treasurer analysis is attached.
4Which legal mechanism and vote threshold apply to each order?394-26 cites M.G.L. c. 44, § 20. 393-26 cites no statute. No Solicitor opinion is attached.
5What explains the $28,490.48 difference between the October 2024 remaining balance of $966,664.98 and the $938,174.50 in 394-26?Nothing in the attachments addresses it.
6What came of the update requested in Paper 412-24?Nothing in the attachments addresses it.
7How large is the River Works gap, and what is the budget history?Partly. The two presentations give snapshots of Phase 1 and Phase 2 costs and funding. There is no full history of adopted and revised budgets.
8What is the complete summary and status of Roosevelt Park Improvement money?Not in the packet beyond general references in the memo and the resident letter.
9What is the status of the $1,198,387.77 Section 108 loan, and what funds the Outdoor Classroom?The resident letter says remediation is funded by a repurposed HUD loan. Nothing states the loan's status or any Outdoor Classroom funding.

What to watch Tuesday

Packet documents
  • City Council Meeting Agenda (Final), October 6, 2026
    View PDF →
  • Mayor Christenson, Information on Papers #392-26, #393-26 and #394-26, September 22, 2026
    View PDF →
  • Malden River Works presentation to the Finance Committee, September 2026
    View PDF →
  • Malden River Works presentation to the City Council, Paper 364-25, December 16, 2025
    View PDF →
  • Malden News Network email to the City Council, September 29, 2026
    View PDF →
Notes
  1. City of Malden, City Council Meeting Agenda (Final), October 6, 2026, Papers 393-26 and 394-26, with attachments. ←
  2. Malden River Works presentation to the Finance Committee, September 2026 (agenda attachment). ←
  3. Brian DeLacey and Bill Muise for Malden News Network, email to the City Council, received September 29, 2026 (agenda attachment). ←
  4. Malden River Works presentation to the City Council, Paper 364-25, December 16, 2025. ←
  5. Mayor Gary Christenson, memo to the City Council, Information on Papers #392-26, #393-26 and #394-26, September 22, 2026 (agenda attachment). ←
  6. Resident letter to the City Council titled Summary of RP Soil Remediation Activities (agenda attachment). ←
A disclosure: MNN is a participant in this story: its September 29, 2026 email to the City Council is attached to both orders. The figures come from the October 6, 2026 Council agenda packet and from the Malden River Works presentations of December 16, 2025 and September 2026. Comparisons and arithmetic are MNN's own and are shown in the text. The letter about Roosevelt Park soil remediation is one resident's account, not a city document. Claude (Anthropic) assisted with organizing and editing the text under the editor's direction; the editor is responsible for the facts and quotations. No source material was altered.
Primary AI assistance: Claude (Anthropic)
Corrections & Feedback: MaldenNewsNetwork@gmail.com
